Beach Haven

9 Aeroview Drive

Last Updated: 5th May2026

Estimated Completion: April 2026

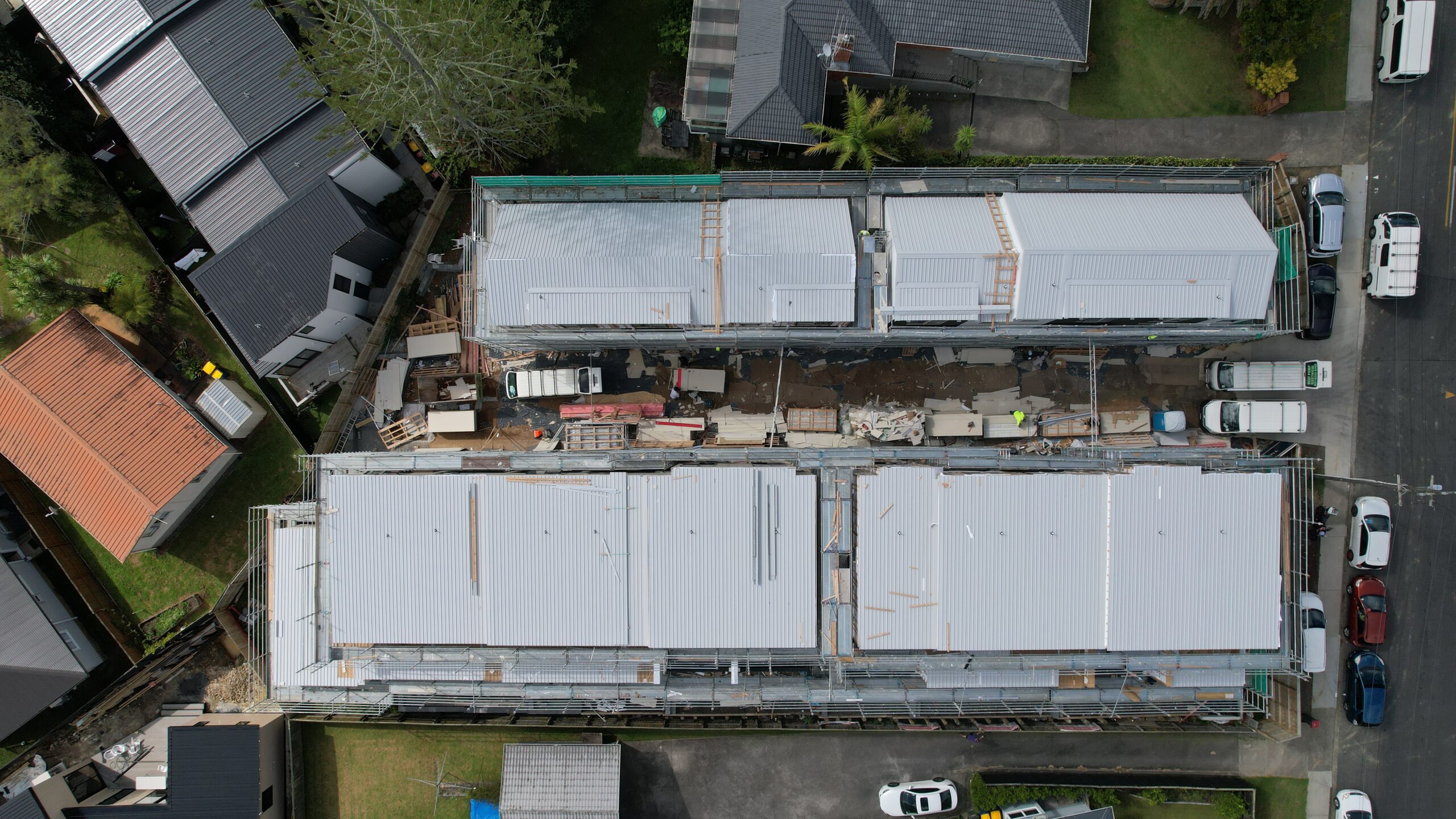

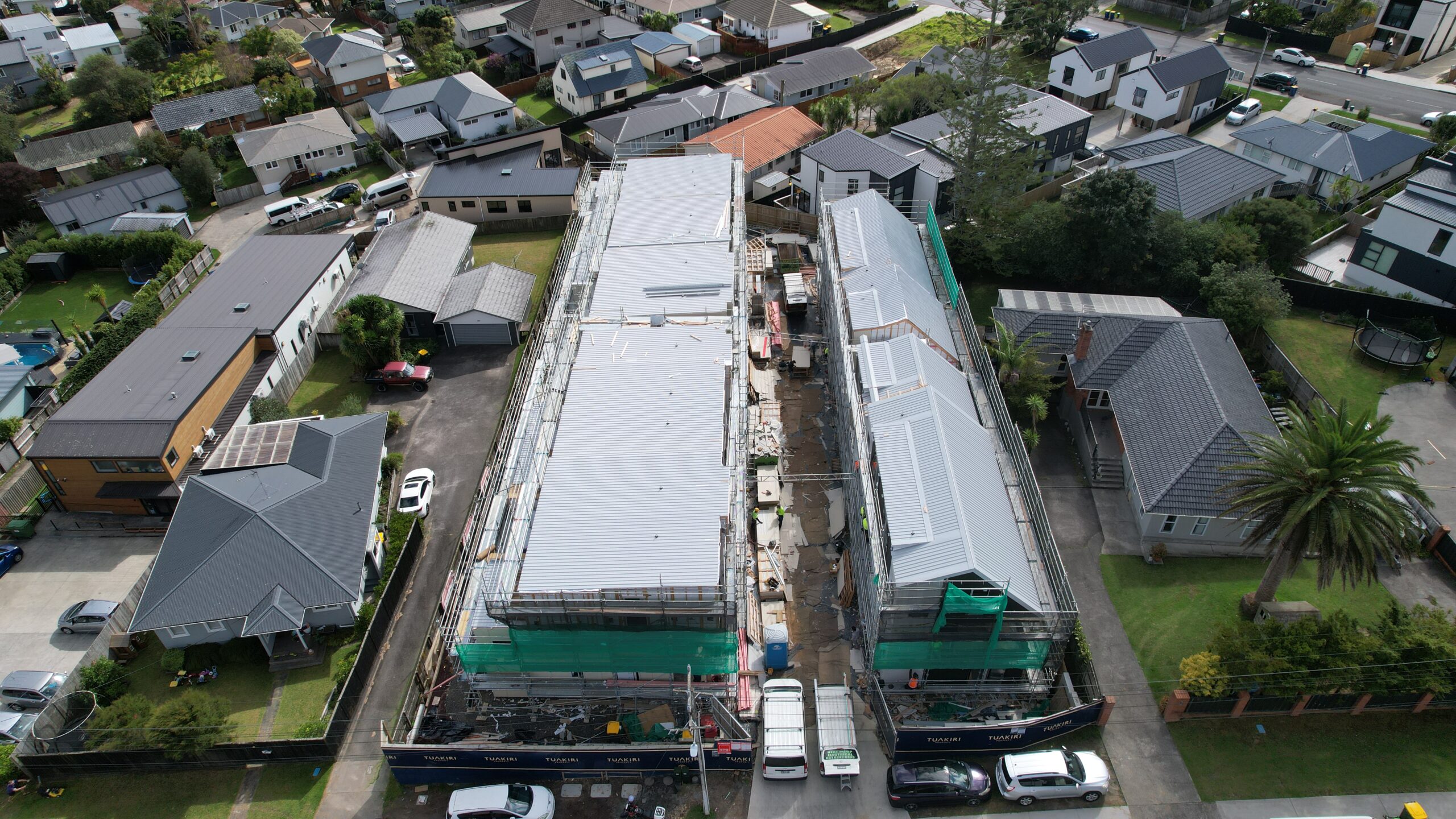

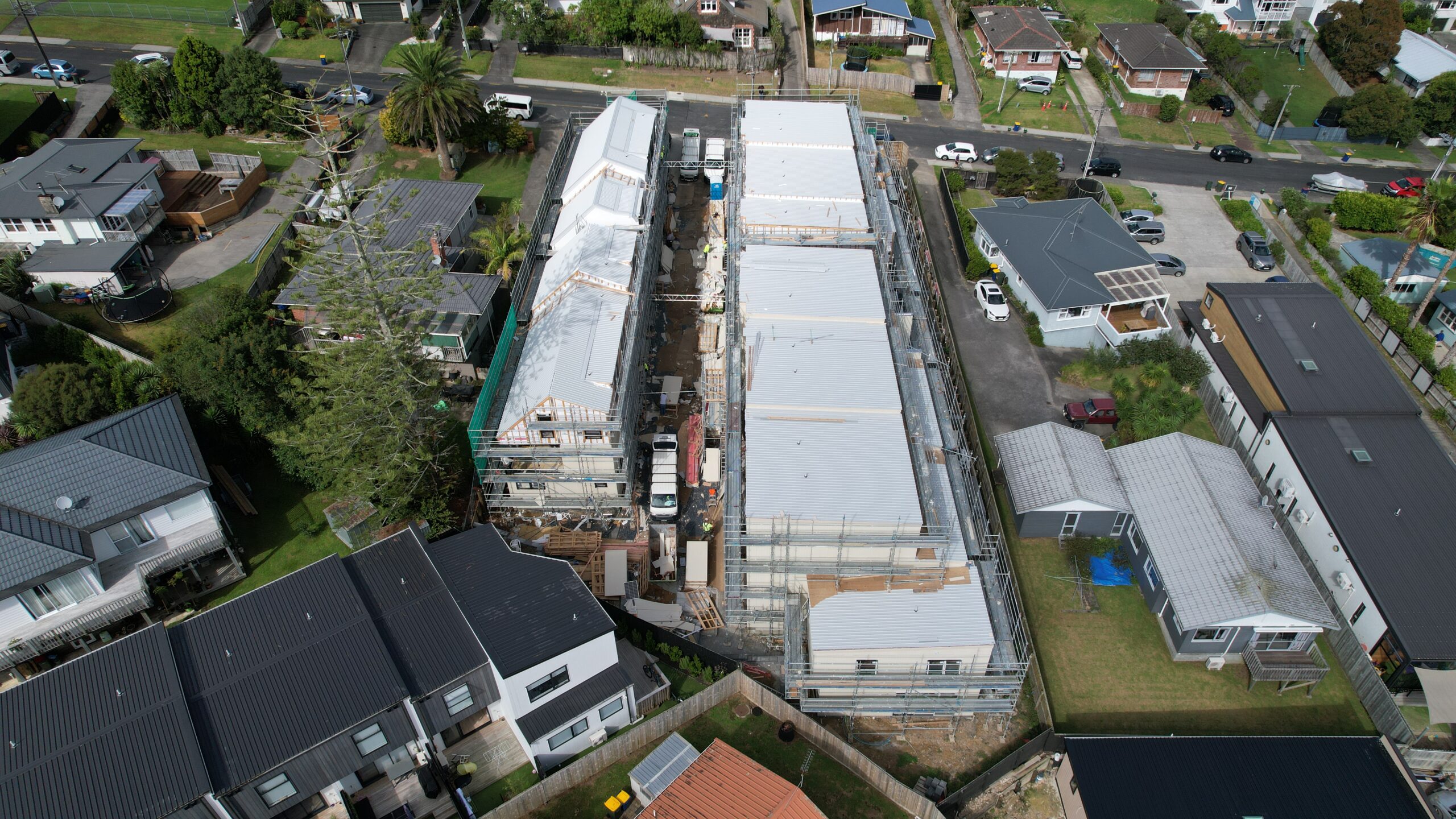

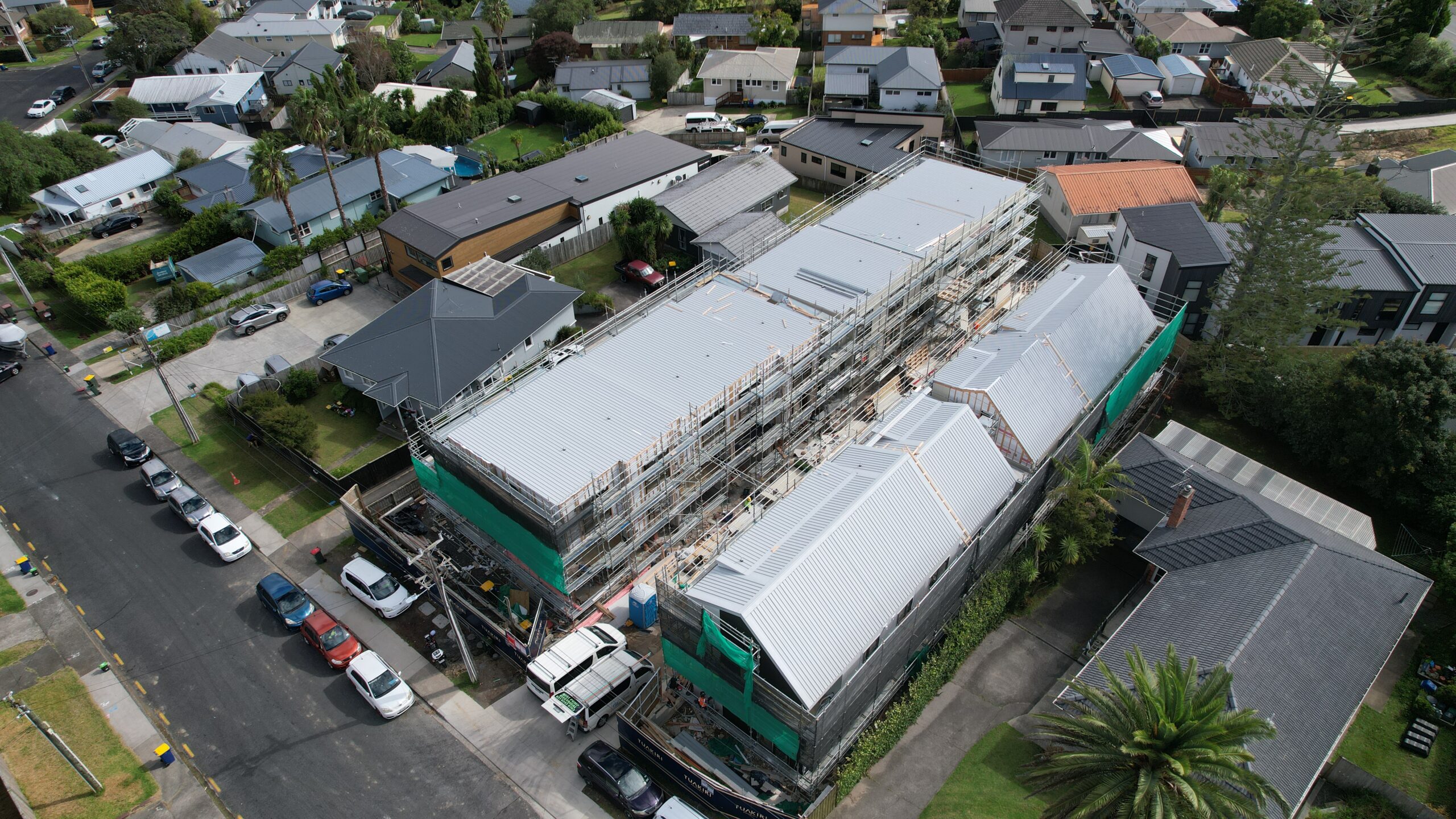

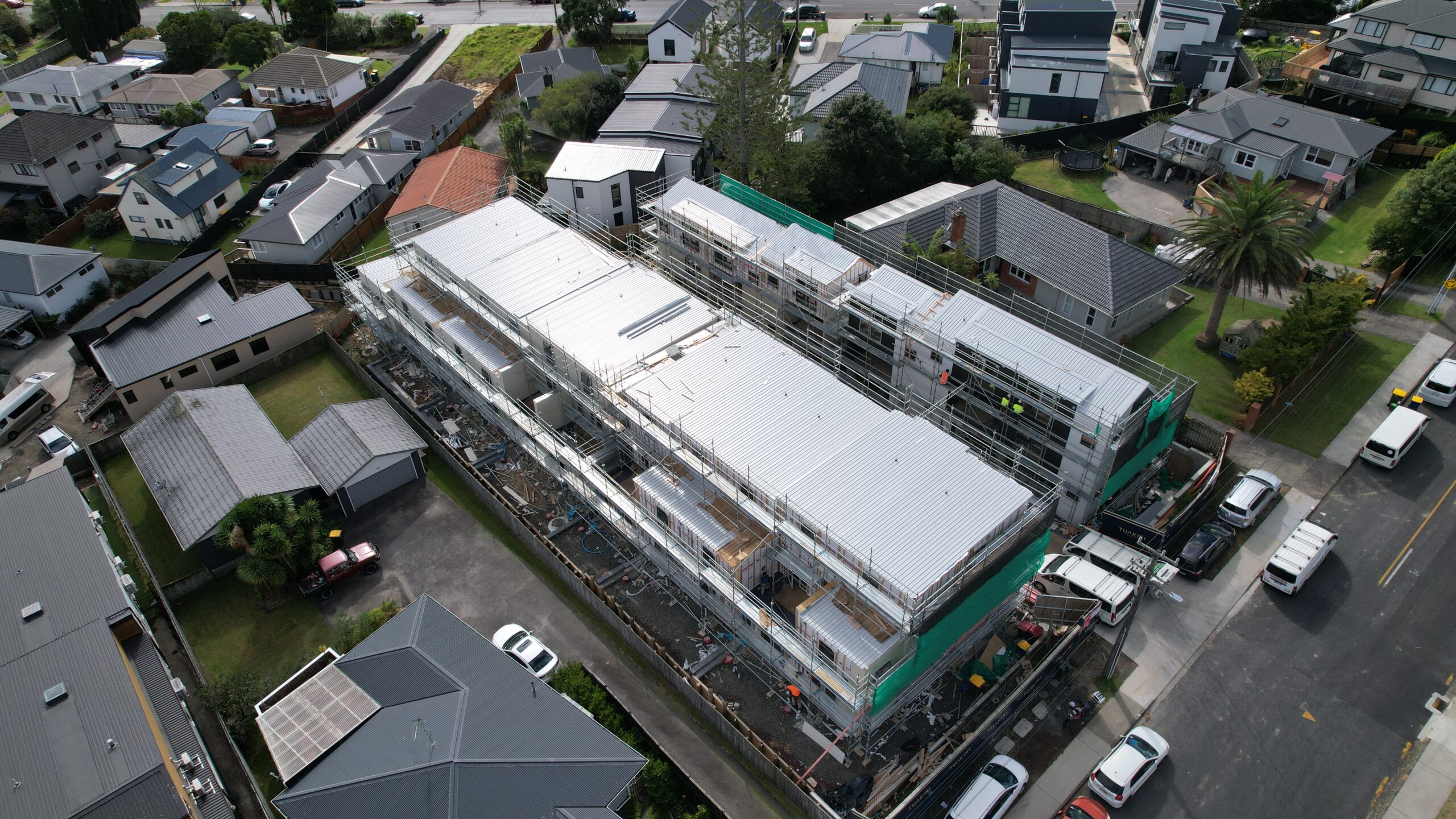

All exterior cladding and painting have been completed, along with all window shrouds. Interior plastering for Blocks C1 and C2 is now complete, and approximately 50% of the scaffolding has been removed. Next week, works will focus on completing interior plastering for Blocks A and B, followed by interior painting and kitchen installation.
